City of Rocky River, Ohio
Public Works - Safety Service Department
The Office of Public Works is responsible for the successful execution of biddable and non-biddable projects throughout the City of Rocky River.
Click here to visit City Surplus Auction to view local items available at auction.
Current Bid Packages and Proposals
Request for Proposals -
2026 Mowing and Maintenance (Due March 27, 2026 at 4pm)
2026 Landscape Bed Maintenance Services (Due April 6, 2026 at 4pm)
Current Construction Projects

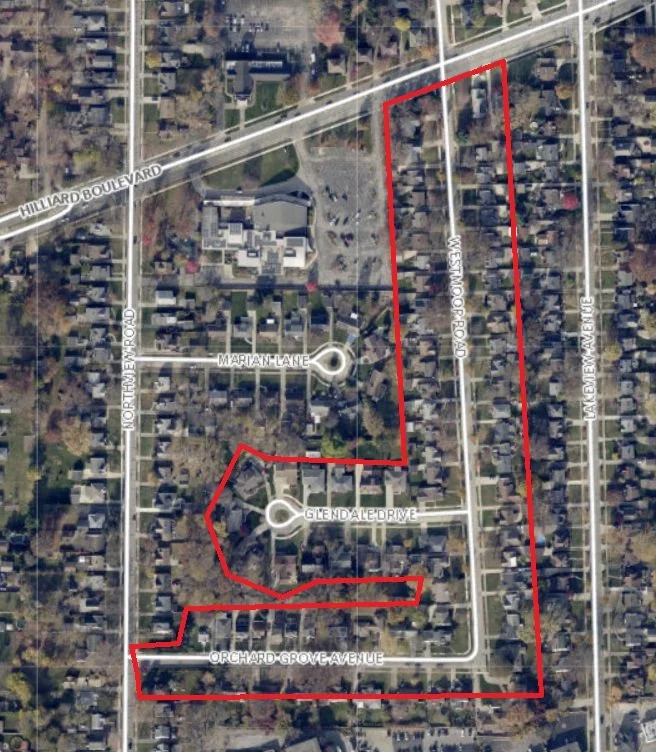

WESTMOOR RD, ORCHARD GROVE AVE, AND GLENDALE DR WATER, STORM SEWER, SANITARY SEWER AND PAVEMENT REPLACEMENT PROJECT
City Council passed legislation to enter a contract with DiGioia-Suburban Excavating, LLC for the Westmoor, Glendale, and Orchard Grove Sewer, Watermain, and Pavement Replacement Project in an amount not to exceed $4,919,685.00 on December 15, 2026. The City received five (5) bids on November 14, 2025, and the bid by DiGioia was $168,572.50 less than the second lowest bid (Fabrizi) and $580,315 less than the engineer’s estimate ($5.5M). The City was awarded $655,034.90 by Cleveland Division of Water as part of the Suburban Water Main Renewal Program to be used for the watermain replacement portion of the project (13.3% of total cost). DiGioia-Suburban Excavating, LLC has received favorable recommendations from the cities of Strongsville and South Euclid. Additionally, they successfully completed the Frazier Drive Project for the City of Rocky River approximately 10 years ago.
The scope of work for the Westmoor (between Hilliard and Orchard Grove) Glendale/Orchard Grove project includes the following:
Sanitary Sewer & Storm Sewer: This work includes the removal of storm sewer and sanitary sewer lines with associated manholes and catch basins, and replacement on Orchard Grove Avenue and Westmoor Road. New storm manholes, storm lateral connections, sanitary manholes and sanitary lateral connections will also be installed. Glendale Drive sewers will not be replaced because they are newer and are in better condition. These sewers are ideal candidates to be lined.
Water Main: This work includes the removal and replacement of approximately 2,300 feet of existing water main.
Pavement: This work includes full depth, full width removal, and replacement of pavement, including curbs, drive aprons, ADA compliant curb ramps and selected sidewalk on Westmoor and Orchard Grove. Glendale will receive full depth pavement repairs, apron replacements, curb repairs, and resurfacing.
*If you would like to be added to the email list for updates regarding this project, please send an email to Chris Vasco (cvasco@rockyriverohio.gov)*
Project Public Meeting Information: January 27, 2026
Buckingham Road, Argyle Oval, and Arundel Road Sewer Replacement Project
The Buckingham Road, Argyle Oval & Arundel Road Sewer Replacement Project is for the replacement of almost 2,000 linear feet of inverted storm and sanitary sewer on public property, as well as the replacement of water mains and connections for all properties, and pavement resurfacing.
The public project area directly services 45 homes and lies within Sewershed 4 in the City of Rocky River. This area was identified as a necessary location for rehabilitation to reduce infiltration and inflow (I/I) as part of our most recent hydraulic study performed in response to an Administrative Order on Consent by the US Environmental Protection Agency (USEPA) requiring the closure of two remaining Sanitary Sewer Overflows (SSOs) within the City. Sewershed 4 serves 356 properties within approximately 134 acres of the City and contains one of the two remaining sanitary sewer overflows (SSO’s), SSO No.302, located at Falmouth Drive and Beach Cliff Boulevard, adjacent to the project location.
Much of the sanitary and storm infrastructure supporting Sewershed 4 is beyond its useful life, in some cases upwards of 100 years old. Coupled with the aging infrastructure, many of the oldest homes in the community are concentrated in Sewershed 4. Portions of sewer system in Sewershed 4 were constructed as over/under sewers, where the sanitary sewer pipe was constructed in the same trench as the storm sewer. Within the manhole, the two sewers are generally only separated by a metal plate which may leak or become dislodged, causing the storm water to flow into the sanitary sewer. This construction technique, which is unique to northeast Ohio, further contributes to I/I problems, particularly as the infrastructure ages. The additional volume of storm water adds to the volume of the sanitary system, and travels to the wastewater treatment plant for treatment, or during high flow events, may be released directly into the storm system, through outfalls into Lake Erie. These overflows are a serious risk to the water quality of Lake Erie and to the health of the public and wildlife who rely on the lake as a natural resource.
The City of Rocky River has worked diligently to perform sewer rehabilitation and has successfully closed 12 of the 14 remaining SSO’s through public works projects. In September of 2009, the USEPA issued Administrative Orders requiring the removal of three (3) SSOs as well as directing the City to perform a City-wide Sanitary Sewer Evaluation Study (SSES). During the intervening period, one of the three SSOs was removed, and SSES Phase I was conducted for Sewersheds 4, 5, and 12.
Sewershed 4 was included in the first phase of the SSES due to the location of SSO No. 302 within its boundary. The SSES investigation included collection system inspections and cleaning, mainline and private property dye testing, flow monitoring, hydraulic modeling and improvement planning for each of the selected sewersheds and has been the basis the City’s calculated approach to the planning and implementation of sewer rehabilitation projects in the community.
The project is expected to cost approximately $5,575,000 with $2,520,000 paid by grant funding awarded by federal Community Project Funding that was awarded in 2022 and $639,930 awarded as part of Cleveland Division of Water’s Suburban Water Main Renewal Program. Construction is expected to commence in the fall of 2024 and be completed late 2025.
Wooster/Shoreland Park
Rocky River City Council awarded the contract for the Wooster/Shoreland Park project to RMH Concrete and Foundations, Inc at a cost not to exceed $513,913.50.

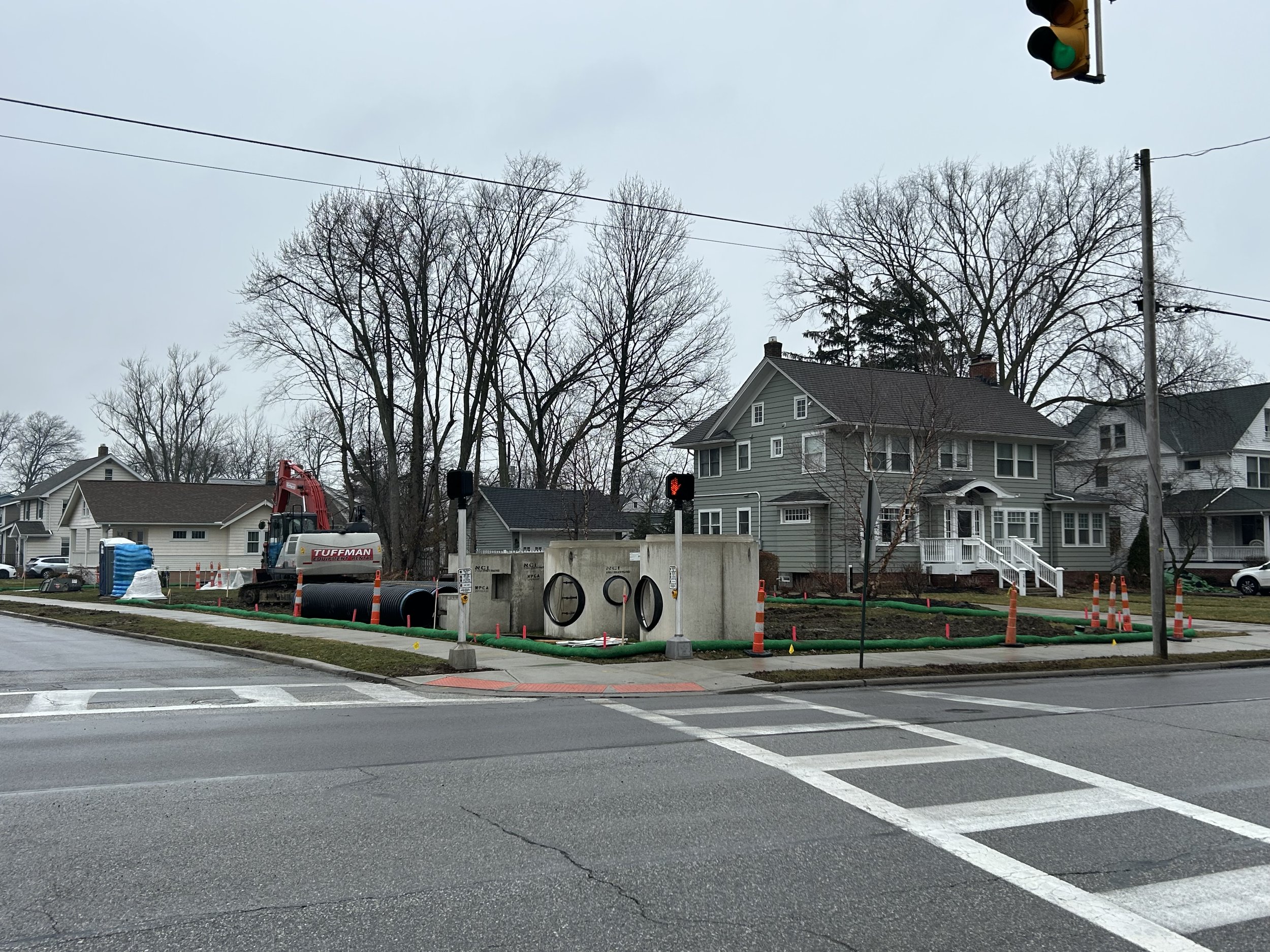

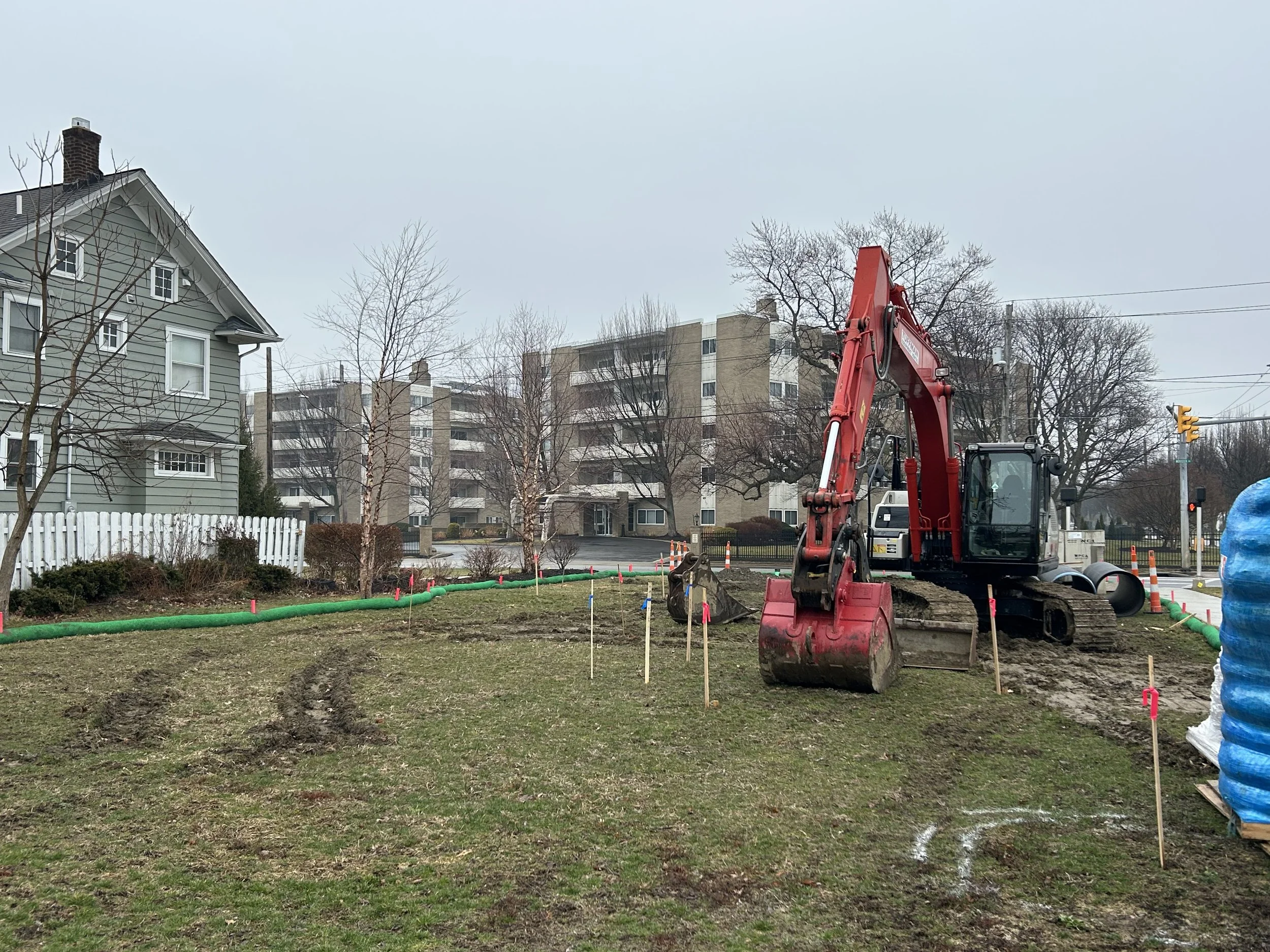

Materials have arrived on site. Crews completed staking on Monday, February 16, and excavation began on Tuesday, February 17. The contractor is currently performing storm sewer connections to the sewer main on Wooster Road.

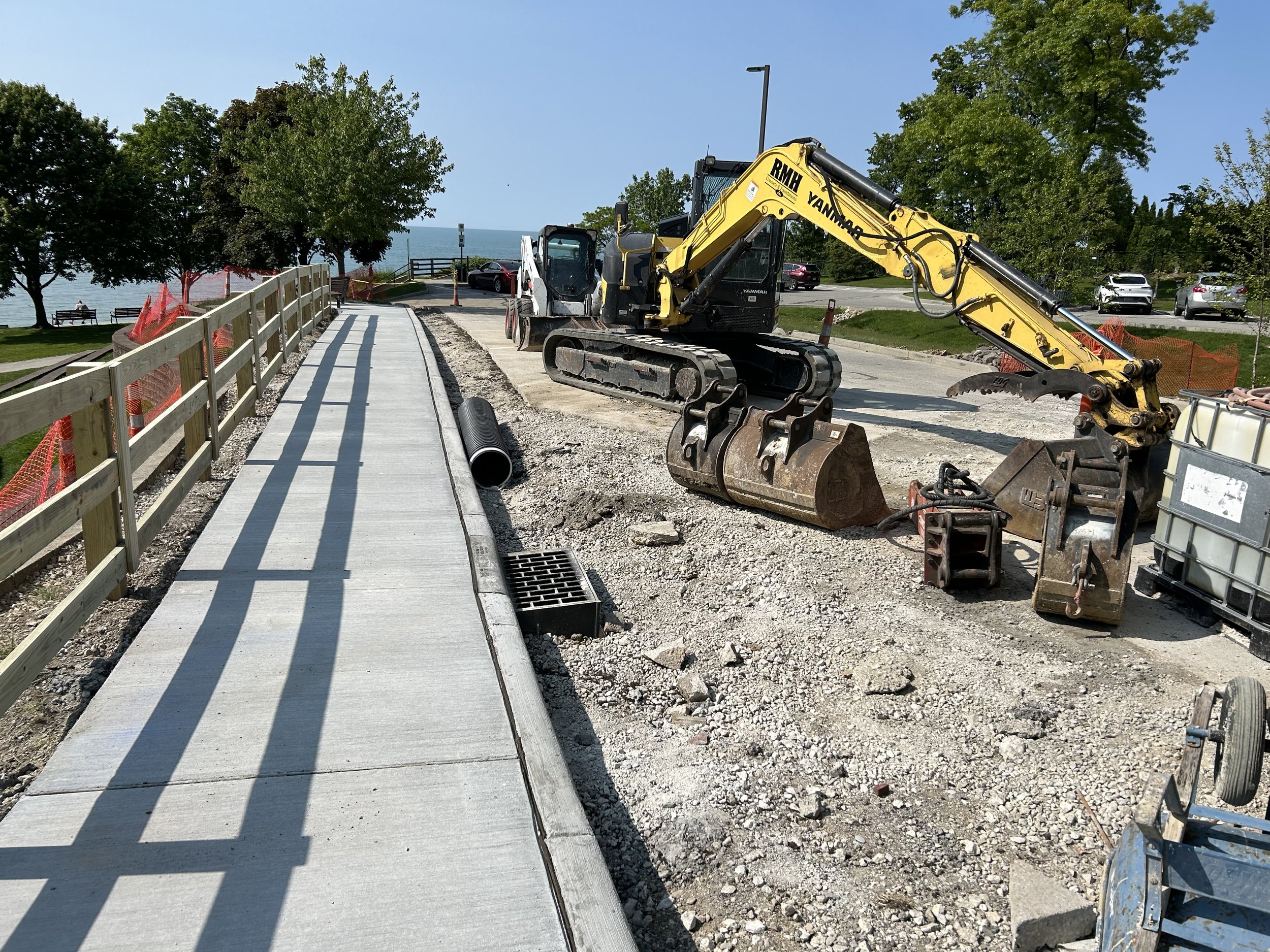

This project will transform the vacant property along Shoreland Avenue at Wooster Road into a passive neighborhood park for area residents. Construction is anticipated to continue through the spring, with completion projected for May/June 2026.
Please note that while this page is updated regularly, more current information may be available. Please reach out to the Office of the Director of Public Safety-Service at (440) 331-0600 for the most up to date information on all of our past, present, and future projects.
Upcoming Construction Projects
Spencer Creek Restoration Project

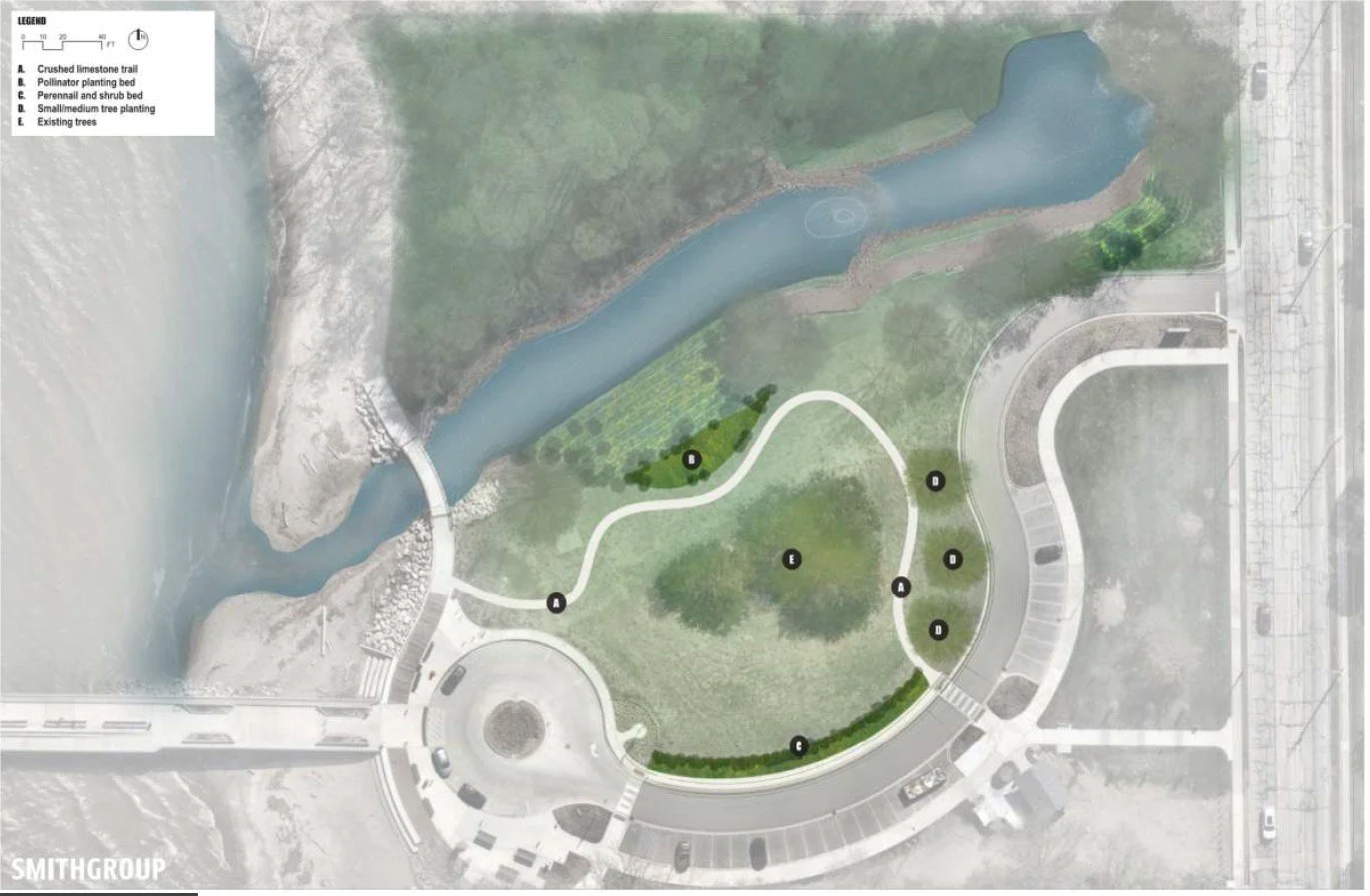

The City of Rocky River is undertaking the Spencer Creek Restoration Project to address environmental degradation, stabilize eroding streambanks, and improve ecological conditions within the Spencer Creek corridor near Bradstreet’s Landing. The project builds upon prior planning and improvement efforts aimed at enhancing the Bradstreet’s Landing area as a community waterfront asset while restoring the health and stability of Spencer Creek.
The project originates from the Bradstreet’s Landing Master Plan completed in 2018, which identified opportunities to improve public access, environmental quality, and recreational amenities in the area. Subsequent projects, including the Bradstreet’s Landing Pier Renovation in 2020 and the Bradstreet’s Landing Upland Improvements Project in 2023, implemented portions of the master plan and enhanced visitor access and park amenities. In 2022, the City secured funding through the U.S. Environmental Protection Agency Section 319 Grant Program, enabling further investigation and design of restoration strategies for Spencer Creek. The restoration effort began in 2024 as the next step in implementing the master plan vision.
Existing conditions within Spencer Creek reveal several challenges affecting both environmental quality and park infrastructure. Field observations identified debris and abandoned pipes within the creek channel, shallow water depths caused by sediment accumulation, and failing slopes that have resulted in tree loss and erosion of adjacent parkland. Additional concerns include steep bluffs near the park entrance, stormwater culverts, and potential flooding risks during high-flow events. These conditions limit accessibility, reduce habitat quality, and threaten the long-term stability of the creek banks and adjacent public spaces.
To better understand these issues and guide design decisions, the City and its consultants conducted a series of technical studies. These included wetland and watercourse delineation, endangered species evaluation, creek habitat assessment, updated topographic surveys, geotechnical investigations, and hydraulic modeling. The studies identified key design considerations such as the composition and stability of creek banks, the presence of steep bluffs, highly variable flow conditions, limited aquatic habitat value, and sediment buildup within the creek bed. These findings informed the development of a restoration concept focused on improving both channel stability and ecological function.
Multiple restoration and stabilization approaches were evaluated to address these challenges. Structural and bioengineering methods considered for slope stabilization included natural block retaining walls, encapsulated soil lifts, soil nail walls, toe boulders with slope layback, anchored rootwads, and timber crib structures. In addition to bank stabilization, the project team explored stream enhancement techniques designed to improve water flow and aquatic habitat. These include floodplain benches to manage high flows, invasive species management with native plantings, live stake planting for bank reinforcement, cross-vane riffle and pool structures to stabilize the channel, instream boulders for habitat complexity, and fish habitat structures that provide cover for aquatic species.
The proposed concept integrates these strategies into a comprehensive restoration plan. The design includes bank stabilization along both sides of the creek, enlargement of sections of the upstream and downstream channel to improve hydraulic performance, and the installation of habitat-enhancing instream features. Native vegetation and ecological restoration measures will improve riparian habitat while reducing erosion and sediment transport. Collectively, these improvements will stabilize the creek corridor, enhance ecological function, and protect adjacent parkland while maintaining the aesthetic and recreational character of Bradstreet’s Landing.
Preliminary cost estimates for the proposed concept total approximately $1.43 million, including $241,000 for east bank stabilization, $949,000 for west bank stabilization, and $243,000 for instream improvements without outside finding of $500,000 in the form of EPA 319 Funding and State Capital Funding. These investments are intended to address both immediate stabilization needs and long-term ecological restoration goals.
The project is advancing through final design and regulatory coordination. Required permits are being obtained from agencies including the U.S. Army Corps of Engineers, the Ohio Department of Natural Resources, and the Ohio Environmental Protection Agency. Coordination is also underway with the Ohio Department of Transportation regarding potential culvert improvements. Project timing is influenced by the schedule for utilizing EPA Section 319 grant funding, which supports implementation of the restoration work.
Upon completion, the Spencer Creek Restoration Project will stabilize the stream corridor, reduce erosion and flooding risks, improve aquatic and riparian habitat, and support the long-term environmental health of the Spencer Creek watershed. The project represents an important step in realizing the broader vision established by the Bradstreet’s Landing Master Plan while protecting and enhancing one of Rocky River’s key natural resources.
Follow this link for a copy of the presentation from the August 25, 2025, public meeting.
